South County Recycling and Transfer Station Project
What's happening now?
Expect longer travel times on West Valley Highway South through this fall
We began construction on the South King County Recycling and Transfer Station in May 2023. Through this fall, travelers should expect to see related road construction on West Valley Highway South. During this time, travelers can expect:
- Traffic slowdowns around the construction site and longer travel times along West Valley Highway South through fall 2024.
- Directional lane closures on West Valley Highway South between the Algona Transfer Station and Iowa Drive. Directional lane closures will be in place 24/7 until work is complete. Temporary traffic signals will direct traffic through the construction site. Northbound and southbound traffic will alternate turns as directed by the signals. Temporary traffic signals will direct traffic through the construction site.
- Construction vehicles exiting and entering the construction site and work crews in the right of ways.
- A limited number of businesses near the construction area may experience utility shutoffs (water, sewer, or power) lasting no more than one day at a time. Affected businesses will hear directly from the construction team in advance of planned shutoffs.
People using West Valley Highway South should plan for delays and longer travel times. Crews will make every possible effort to limit the effects of construction on the surrounding community and complete work as safely and efficiently as possible.
Expect construction work on 11th Avenue North starting July through this fall
King County will be upgrading the sewer line under 11th Avenue North in Algona to accommodate the new South County Recycling and Transfer Station. Work begins as soon as early July and is expected to be complete by October 2024. During this time, travelers can expect:
- Work will occur Monday through Friday on the north side of 11th Avenue North from Celery Street west to the end of 11th Avenue North. The majority of the work will be done during the daytime, though some limited night work may be necessary.
- Work will include installing pumping equipment, removing pavement, installing a sewer line, connecting residences to the new sewer line, and restoring pavement.
- Construction vehicles exiting and entering the construction site and work crews in the right of ways.
Access to residences will be maintained at all times. Signs and flaggers will provide direction as needed during active work. Mail and package delivery access to residences will also be maintained. Residents living along 11th Avenue North can also expect:
- Nearby residents can expect noise, vibration, vehicle exhaust, and dust throughout construction. Noise types could include beeping, engine and machinery sounds, and loud vacuuming sounds.
- Residents will see and hear construction vehicles on and idling when necessary for vacuuming and other work. Truck idle times will be monitored, and engines shut off when not in use.
- A one-day sewer shutoff will be coordinated with residents for mid-August to connect houses on 11th Avenue North to the new sewer line. Crews will coordinate with residents to schedule shutoffs.
- The construction area will occupy one lane of traffic on 11th Avenue North. One lane of traffic flow will be maintained on 11th Avenue North at all times.
- Later in the project, there will be a brief sewer service outage for each residence on 11th Avenue North. The outage will be announced ahead of time and coordinated with residents.
- Road pavement will be restored at the end of the project.
Crews will make every possible effort to limit the effects of construction on the surrounding community and complete work as safely and efficiently as possible, however, residents who work from home or rest during the day may be impacted by daytime work.
Sign up for our GovDelivery email updates to get the latest project and construction updates in your inbox.
Construction
Overview
King County is constructing a new Recycling and Transfer Station just north of the existing Algona Transfer Station. The new facility will include commercial and public recycling drop-off areas, hazardous waste disposal areas, and an administrative office.
Construction schedule
Construction began in spring 2023, and the new station is scheduled to open to the public as soon as summer 2026. Upcoming work in 2024 includes construction on West Valley Highway South, which may include temporary lane closures and detours.
- Improvements to West Valley Highway South: Work is expected to begin as early as late May and last through October.
- Upgraded sewer line on 11th Avenue North: Work is expected to begin as early as July and last through September.
- New culvert under West Valley Highway South: Work is expected to begin and finish in July.
What to expect during construction
People who live, work, and travel in the area can expect occasional noise, vibration, and dust throughout construction. Crews will make every possible effort to limit the effects of construction on the surrounding community.
Occasional traffic shifts and lane closures along West Valley Highway South will be required to complete some construction activities. Signs and flaggers will provide guidance during roadwork.
King County is committed to being a good neighbor and will work directly with the community throughout the project to minimize construction impacts whenever possible. Residents can expect:
- Construction updates and news via notices, emails, and this website.
- One-on-one problem solving with residents directly impacted by construction.
As construction begins, you can stay informed and involved through the following channels:
- Sign up for our GovDelivery email updates to get the latest project and construction updates in your inbox. You can sign up or opt out at any time.
- Invite a member of the project team to give a virtual presentation to your organization or group.
If you have questions or comments, please contact Karen Herndon, Project Manager, via email or by calling 206-477-0529.

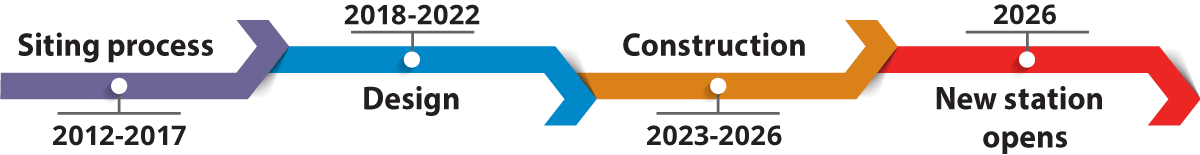

![South County project schedule.](https://cdn.kingcounty.gov/-/media/king-county/depts/dnrp/waste-services/garbage-recycling-compost/solid-waste-facilities/facility-projects-renovations/south-county/images/overall-project-schedule.png?rev=f289a72a8e694b28b79da8e7275e0a4c&la=es-ES&h=155&w=1200&hash=D3325DF1830D16D3A989391559437115)
Benefits
Community advantages
In addition to expanded services, the new South County station will bring additional benefits to the neighboring community including apprenticeship and training opportunities, job creation and economic investments, environmental education, public art additions, and West Valley Highway South road improvements.
Expanded services
The new South County Recycling and Transfer Station will offer a wider variety of services for customers than are currently available at the Algona Station. Station services will include:
- Recycling for appliances, glass, metals, paper, plastics, wood, yard waste, and more
- Hazardous waste disposal for products from homes and qualifying small businesses
- Garbage disposal
Site selection
In 2006, the King County Council approved a plan to modernize its recycling and waste disposal facilities throughout the county.
As part of that plan, the County began looking for a location to build a replacement facility for the aging Algona station in 2012.
In 2017, the site at 35101 W Valley Hwy S was selected. This site is located just north of the existing Algona Transfer Station.
Read the 2006 Solid Waste Transfer and Waste Management Plan (646KB)
Our Solid Waste Division project team worked with representatives from the surrounding community as the design for the new station was developed. This group was known as the Design Advisory Committee and met regularly throughout the process.
The team also worked with the cities of Algona, Auburn, Pacific, and Federal Way and with employees who worked at existing County transfer stations. The community was also asked to share their input online and at in-person events. More information about the public engagement process can be found below. Final design for the facility was completed in June 2022.
Living Building Challenge
The Living Building Challenge (LBC) is an opportunity for projects to create a positive impact on the human and natural systems that interact with them. Projects that follow the LBC framework create positive environmental, sustainable, and regenerative impacts. King County has committed itself to registering at least 20 LBC projects by 2025.
Structures that adhere to the LBC design framework don’t just focus on one area of environmental impact, but instead benefit their surroundings through a variety of categories. The South County Recycling and Transfer Station project will focus on the categories of Energy, Place, Equity and Beauty.
The South King County Recycling and Transfer Station will include the following features that align with the LBC design framework:
- Solar panels
- Sustainable construction materials
- Natural light
- Native plant life
Enhancements
The new South County Recycling and Transfer Station will use modern design elements that address many of the challenges that are encountered at older stations.
Controlling air - Modern stations feature walled-in structures to contain air flow and hold in odors. Misters are also used to suppress dust and odors.
Enhancing lighting - Modern stations harness the power of natural light by using transparent materials for window and roofing to limit the use of electricity, saving energy and money.
Containing sound - Modern stations reduce noise from equipment and vehicles by using enclosed-building designs, sound absorbing landscaping, and by setting the buildings further back or using sound barrier walls.
Mitigating traffic - Compacting equipment and additional driving lanes allow modern stations to move vehicles through the site quickly and reduce the number of trucks coming to and from the location each day.
Features
The new South County Recycling and Transfer Station will feature a number of environmental and community enhancing features including:
- The use of solar panels
- Tributary realignment and habitat enhancements
- The capture and use of rainwater from the site
- The use of sustainable construction materials
- Landscaping with native, drought tolerant plants
Public involvement
Public involvement is an essential part of developing designs or plans for any new station. As we began to evaluate a new station for South County residents, our staff asked the community to share what was important to them.
During that outreach, the community said that recycling, garbage and hazardous waste disposal were important services. They also shared that they were concerned about traffic, odor, and impacts to the stream and wetlands on the site.
We also asked the community what benefits they would like to see from a new station. Job training and apprenticeships, walking and biking trails, and environmental impacts were some of the most common responses.
Using this information, we worked with representatives from South County cities, the Muckleshoot Indian Tribe, businesses, residents and solid waste hauling companies to develop a design for the South County Recycling and Transfer Station that would serve the communities needs and desires.
Public art
![Public art for the South County Recycling & Transfer Station](https://cdn.kingcounty.gov/-/media/king-county/depts/dnrp/waste-services/garbage-recycling-compost/solid-waste-facilities/facility-projects-renovations/south-county/images/scrts-public-art-scraps.jpg?rev=c9e9a79ba6b342e0a6fbb68ef33db0b6&la=es-ES&h=574&w=1000&hash=91C0EC7D56FD480BE2C03B7CB9C3AE1D)
In 1973, King County created the 1% for Art Program. This program requires that 1 percent of funds from capital construction projects, such as the South County Recycling and Transfer Station, be set aside for public artwork. 4Culture, the county's cultural services agency, has commissioned four regional artists to develop site-specific pieces for the new facility:
- Artists Tyson Simmons, Keith Stevenson, and Sam Obrovac of the Muckleshoot Indian Tribe’s Culture Division will create a signature sculpture carved from trees felled on the project site as well as concrete patterning and aluminum medallions for the entry retaining wall. Both artworks reference Muckleshoot stories of air, land, and sea, representing ancestral teachings about the interconnectedness of the world around us.
- Evan Blackwell, visual artist and faculty member at Evergreen State College, is developing a body of work informed by engagement activities and materials sourced during a multi-year residency. Select pieces will be installed in the lobby of the administrative building and in the surrounding landscape.
Project schedule
Updated April 2024 (subject to change)
Date | Actions/Events/Public meetings |
---|---|
July 2012 - Sep 2016 |
Potential locations for the new facility are identified, criteria to evaluate locations are developed, an Environmental Impact statement is completed, and multiple community meetings are held. |
Feb 2017 |
King County selects the site 35101 West Valley Highway S, Algona, WA as the location for new South County Recycling and Transfer Station. |
Nov 2018 | Preliminary station design begins. |
Nov 29, 2018 | First Design Advisory Group meeting. |
Dec 12, 2018 |
Open House is held at Algona City Hall, 200 Washington Blvd., Algona for community members interested in learning more about the project and providing input on design. |
Feb 8 - June 2, 2019 | Online open house is held. Community members are invited to give their input on the design of the new station, including ideas on sustainable design features, services to be offered, and impacts and benefits to the community. |
Feb 28, 2019 | Second Design Advisory Group meeting. |
May 30, 2019 | Third Design Advisory Group meeting. |
Fall 2019 - Winter 2020 | Value Engineering Study and environmental analysis and studies (noise, geotechnical, traffic, wetlands and stream) are performed. |
Feb 14, 2020 | 4Culture initiates Call for Artists to create public art for the project. |
Aug 2020 |
4Culture announces a rtists selected for the project. |
May 28, 2020 | Fourth Design Advisory Group meeting. |
July 1, 2021 | Fifth Design Advisory Group Meeting. |
Aug 25, 2021 | Online Open House is held. This is an opportunity for community members to learn more, ask questions, and give input to project team on 60% design. |
Summer 2021 - Fall 2022 | Station final design. |
May 18, 2023 | Construction groundbreaking |
2023 - Spring 2026 | Construction of new facility. |
Summer 2026 | New facility opens to the public. |
Project documents
Project updates
Environmental Impact Statement (EIS) Drafts
Draft EIS Intro and Chapters 1 & 2 (5MB)
Draft EIS Chapters 4, 5, & 6 (226KB)
Draft EIS Appendices A - D (8MB)
Final Environmental Impact Statement
Final EIS Intro, Summary, and Chapters 1 & 2 (5MB)
Final EIS Chapters 4, 5, & 6 (237KB)
Final EIS Appendices A - F (9MB)
Additional project documents
Virtual Open House Presentation - January 27, 2022 (3MB)
Virtual Open House Presentation - August 25, 2021 (3MB)
Equity Impact Review Report (1214KB)
Determination of Significance (119KB)
Revised Scope of Environmental Impact Statement and Extension of Scoping Comment Period (95KB)
Notice of Second Extension of Scoping Comment Period and Public Scoping Meeting (1871KB)
South County Recycling and Transfer Station Siting Report with Addendum (4MB)
